Field Service starter
Risk assessment and method statement
Plan a job safely: hazards and controls, the method, protective equipment and permits, emergency details and a briefing record.
- Work Order
- Field Service
4 pages, as Docable made them from sample records with the HelioGrid sample brand. The company, people and figures are made up.
- Page 1

- Page 2

- Page 3

- Page 4

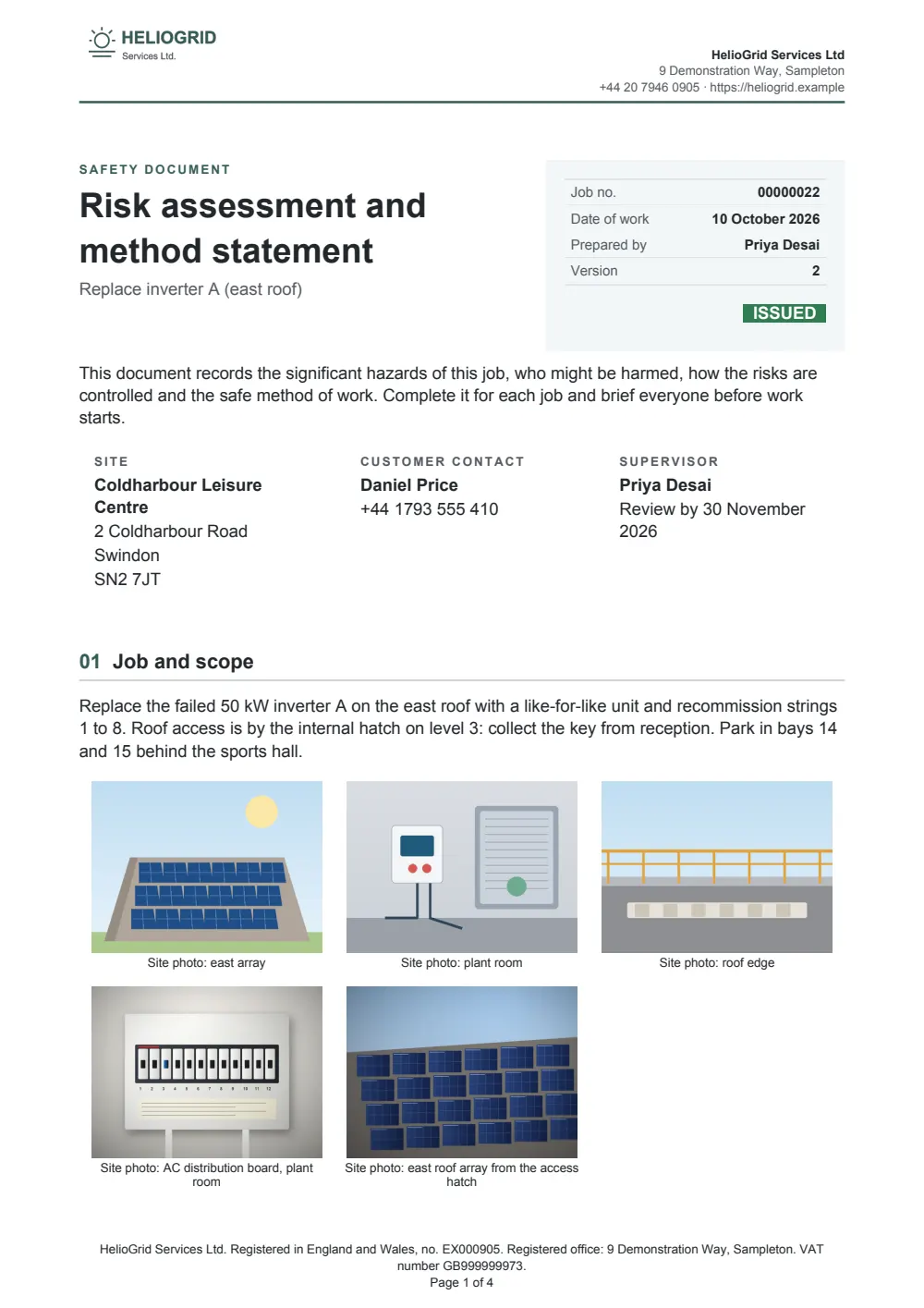

A risk assessment and method statement (a job hazard analysis with US wording) on a Work Order: a title panel with the job, date, author, version and an issue badge; the site, customer contact and supervisor; the job and scope with site photos (only when there are some); the engineers booked; a hazard table with example controls and residual-risk badges (5 x 5 scores or low, medium and high, picked when it is made); the work plan's steps (left out in an org without work plans) and a general method; tick boxes for protective equipment, access equipment and permits; emergency arrangements asked when it is made; a briefing record; the supervisor's and customer's signatures; document control; and a DRAFT watermark until it is issued.
Needs Field Service in the org; shows more when Work Plans is on.
More for Field Service.
